When to Order Halloween Packaging: Deadlines, Lead Times, and the October Cutoff

Elena Vasquez·August 9, 2026·7 min read
When to Order Halloween Packaging: Deadlines, Lead Times, and the October Cutoff

The Short Answer

Order Halloween packaging by July 28 for standard domestic production. That is the recommended date, and it carries buffer. The latest possible dates are August 8 for offset, August 25 for digital, and September 20 for rush. Supplier lead time runs about three weeks on a digital run and six to seven weeks on offset with a physical proof.

October 31 Is Not Your Deadline

The calendar date is when your customer opens the product. Your operational deadline sits roughly seven weeks earlier. Retailers merchandise Halloween sets in the last week of September and pull them the morning of November 1. DTC brands need inventory packed and photographed before October ad spend begins. Bakeries take October pre-orders and need filled boxes on the bench first. All three point at the same target: printed boxes at your facility by September 12 to 15.

The Backward Timeline From October 31

The recommended schedule, not the tightest one. Assumes domestic offset production, a physical proof, and ground freight.

MilestoneTarget dateWhat has to happen
HalloweenOctober 31Product is in the customer’s hands
Last consumer ship dateOctober 24Ground transit plus a weekend buffer
Peak sell-through beginsOctober 15Retail and DTC demand concentrates here
Product listed and photographedSeptember 26Listings and October ads go live
Fill, pack, and QCSeptember 15 to 25Seven to ten business days
Boxes delivered to your facilitySeptember 12The hard target date
Freight departs the plantSeptember 3Five to seven business days by LTL
Production startsAugust 19Ten to fifteen business days on offset
Physical proof arrives and is signedAugust 17 to 18Five to seven days to build, two in transit
Digital proof issued and approvedAugust 5 to 6Layout and knife lines only, not color
Artwork and dieline submittedAugust 3Print-ready files only
Quote requested and order placedJuly 28Locks press capacity and releases the dieline

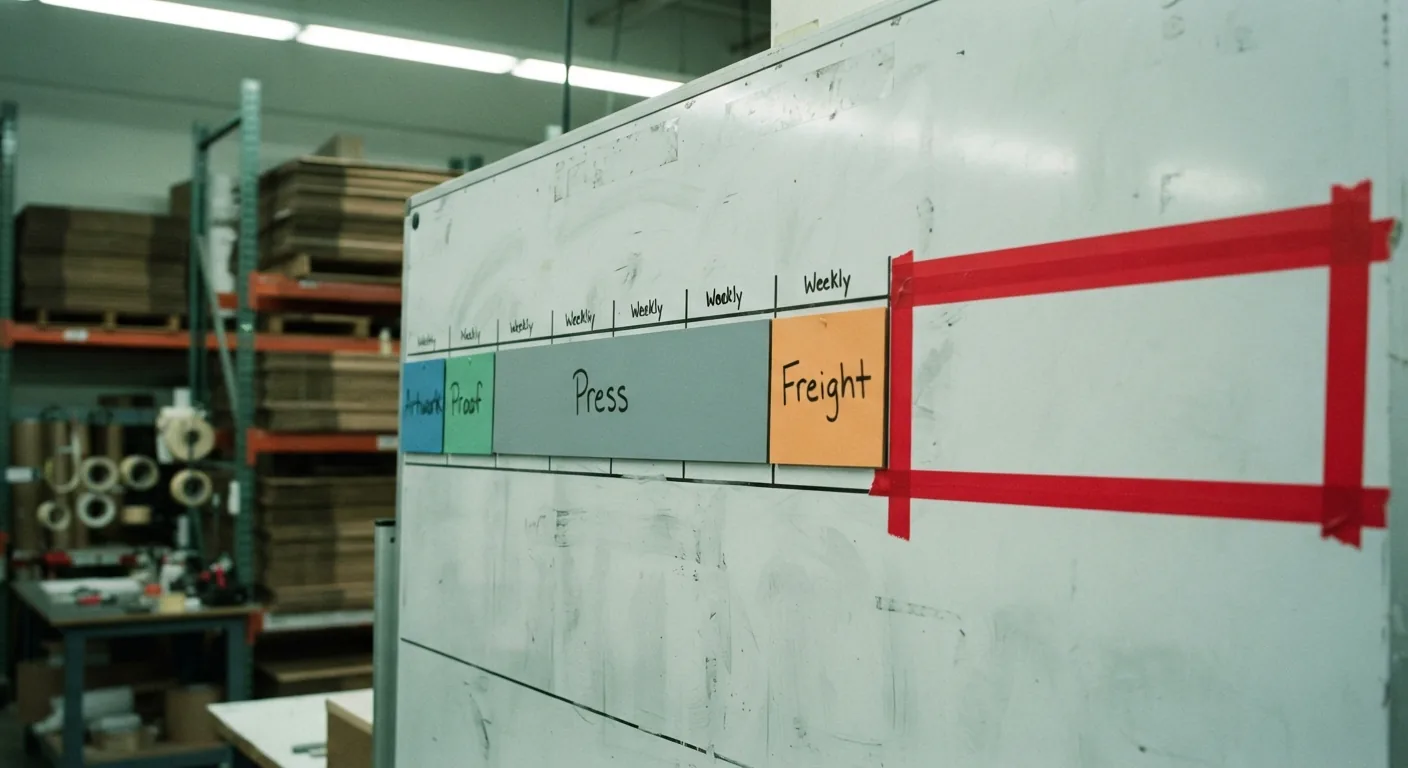

A production planning whiteboard in a print shop showing a horizontal seasonal schedule with colored cards labeled Artwork, Proof, Press, and Freight marked off in weekly increments, with a red tape block marking the closed October window
The same timeline as a printer sees it: artwork and proof are days, press and freight are weeks, and the red block is the window that has already closed.

Where First-Time Buyers Lose the Most Time

The fill window and the freight leg are where first-time buyers lose time. A pallet of flat folding cartons moving LTL across three states takes five to seven business days, and that leg is invisible on most supplier quotes because it sits between the plant and your dock rather than inside the production estimate. The fill window is the other blind spot. Seven to ten business days of filling, packing, and QC has to happen after the boxes land and before anything is photographed or listed, and no amount of rush production buys that time back.

Halloween Packaging Lead Time, Stage by Stage

Artwork and dieline take three to five business days. Your printer supplies a dieline template sized to your product. Your designer places artwork on it at 300 DPI in CMYK, with a 3mm bleed and all fonts outlined. Files arriving as RGB JPEGs restart this stage. Halloween palettes make this worse than usual: deep blacks need a rich black build rather than 100% K, and orange spot matches like Pantone 021 C or 165 C drift noticeably when converted to process. Proofing takes two business days digital, nine to eleven with a physical proof. A digital PDF proof turns around in one to two business days and confirms layout, copy, and knife lines. It does not confirm color. A physical prototype adds five to seven business days to build plus two in transit, and it is the only way to see how a matte laminate flattens your orange or how a glow ink reads under retail lighting. Production runs five to twenty-five business days depending entirely on print method and structure.

Print methodTypical run sizeProduction time
Digital250 to 2,000 units5 to 8 business days
Offset litho on folding cartons2,000 to 25,000 units10 to 15 business days
Flexo corrugated, one or two colors1,000 units and up8 to 12 business days
Litho-laminated corrugated1,000 units and up12 to 18 business days
Rigid boxes, hand assembled500 units and up15 to 25 business days

Freight: Three to Eight Business Days

Domestic LTL freight runs three to eight business days depending on distance. Overseas ocean freight adds 25 to 40 days port to port before drayage, so a late-July order placed offshore is already a September order.

Common Mistakes That Cost Two Weeks

Waiting for final product photos before requesting the dieline. The dieline is built from product dimensions, not imagery. Request it the day you confirm the size. Treating a digital proof as color-approved. It confirms layout and knife lines only. Quoting three suppliers in sequence instead of in parallel. That habit burns a week of press capacity. Sizing the run to October demand alone. The reorder pays a second makeready at full setup.

Standard Versus Rush: The Honest Cutoff Dates

The timeline above uses July 28 because it leaves slack. Below is the other end: the last date each route still works. Both standard rows assume you skip the physical proof.

Order typeLatest possible order dateDelivery windowCost premium
Standard offset, domesticAugust 8September 10 to 15None
Standard digital, domesticAugust 25September 18 to 24None
Rush digital, expedited freightSeptember 20October 8 to 1425 to 40 percent
Stock box plus printed labelOctober 6October 15 to 20Label cost only
Any custom cartonAfter October 10Not achievableNot offered

What Rush Halloween Boxes Actually Cost

Every week past late July removes one option from the menu. By late September the only lever left is print method. By mid-October it is a label. Rush pricing stacks. Production fees typically add 25 to 40 percent to the print line. Expedited freight can double the shipping line, and on a single-pallet order that difference often exceeds the print surcharge. Rush runs also lose you the physical proof. The quieter cost is scheduling. A rush job jumps the queue, so the press window is short and there is no room for a re-plate. Most operators who have run one report the same outcome: one detail was not what they approved. Seasonal packaging deadlines are unforgiving for a structural reason. A Halloween box has no salvage value on November 1. A missed Christmas order can ship in January as winter stock. Orange bats cannot.

If You Have Already Missed the Window

One fallback is a stock box with a seasonal overlay. Order plain white or kraft corrugated boxes from stock inventory, then apply a full-coverage printed label or a wraparound band printed digitally in three to four business days. Label runs are far shorter than carton runs. The other is a printed sleeve. If you already stock branded mailer boxes, a paperboard sleeve printed on one side carries the entire seasonal design and slides over inventory you own. Sleeves print in five to seven business days and store flat. Both sacrifice the interior print and structure of true seasonal custom packaging. Both beat a plain brown box.

Two Ways to Compress the Timeline Without Paying Rush

Run one dieline across the seasonal line. Four Halloween SKUs should be four artwork versions on one carton size, not four structures. One dieline means one tooling setup, one makeready, one shipment. Order the season, not the SKU. One late-July order covering Halloween and Thanksgiving spreads setup costs across both and locks capacity before the autumn queue fills. When you are ready to lock a date, request a packaging quote with your quantity, dimensions, print method, and required in-hand date. A quote that names the delivery date is the only one worth comparing.

Frequently Asked Questions

Elevate Your Brand With Custom Packaging

Get packaging designed for your brand. Free shipping. No minimums.

Start Today
E

Author

Elena Vasquez

Elena Vasquez spent nine years as a production scheduler and then procurement lead for two seasonal gifting brands, where she booked press capacity for Halloween and holiday programs every summer and personally missed one October deadline she still brings up in kickoff meetings. She now writes about packaging lead times, press scheduling, and freight planning for Packify.
